At approximately 1:22 a.m. EDT on June 24, 2021, Champlain Towers South — a twelve-story, 136-unit beachfront condominium completed in 1981 at 8777 Collins Avenue in Surfside, Miami-Dade County — partially collapsed. Ninety-eight people died. Eleven survived with non-fatal injuries. The building's sister towers, Champlain Towers North (1982) and Champlain Towers East (1994), still stand. Five years later, the National Institute of Standards and Technology has identified the pool deck as the most likely origin of the failure, the Florida Legislature has passed four waves of structural and governance reform, the Dubai-based developer that paid $120 million for the site has yet to sell a single unit in the replacement tower, and not a single individual has been criminally charged.

This is a comprehensive look at what has actually changed in Florida community-association law and operations in the five years since Surfside — and what remains structurally unresolved as the anniversary approaches. Pair this with our Florida condo SIRS reserve funding guide, our milestone inspection guide, our Fannie Mae blacklist guide, our developer takeover guide, and our 2026 legislative session recap.

This article is general information for Florida community-association board members, owners, and residents. It is not legal advice. The post-Surfside legal and regulatory landscape continues to shift; verify any specific provision at flsenate.gov or with a licensed Florida community-association attorney before relying on it.

What NIST found, five years on

The National Institute of Standards and Technology has been investigating Champlain Towers South under the National Construction Safety Team Act since 2021. NIST announced in September 2025 that technical work was complete and a draft summary report plus six technical reports would be released in Spring 2026. Lead investigators Judith Mitrani-Reiser and Glenn Bell have communicated preliminary findings through 2024 and 2025 updates.

The most significant finding is that the collapse did not start in the tower. WLRN reported NIST's revised timeline: the pool deck and street-level parking deck failed at least seven minutes before the tower came down. The initial failure point was a slab-column connection in the pool deck. From there, NIST has identified a cluster of contributing factors:

Mitrani-Reiser, in NIST's September 2025 update, summarized the finding: "This tragic event has revealed flaws in our systems, and quality is at the heart of it." Bell stated: "It is more likely that the failure started in a pool deck slab-column connection." NIST has signaled forthcoming code recommendations covering mandatory special inspections for quality control, comprehensive records retention beyond initial drawings, and enhanced quality assurance during construction. The full final report and recommendations are expected in 2026.

The four legislative waves

Florida's post-Surfside legislative response has come in four distinct waves over four legislative sessions, each progressively tighter on requirements then progressively softer on enforcement and timelines as the financial pain on owners became visible.

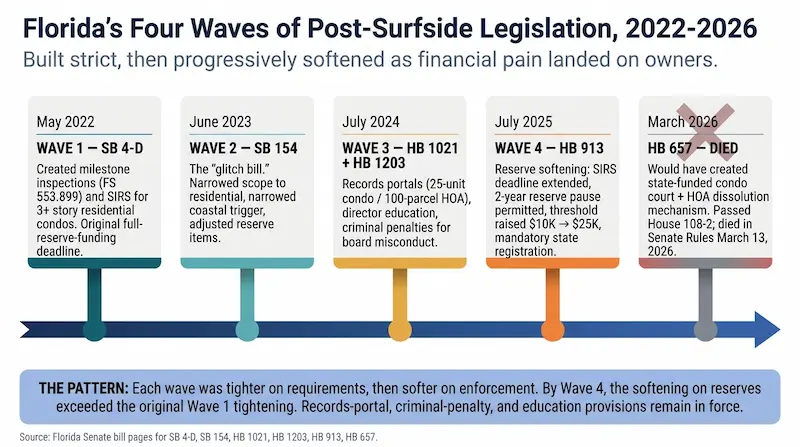

Timeline infographic showing the four waves of post-Surfside Florida legislation from 2022 to 2026, with wave one as SB 4-D in 2022 creating milestone inspections and SIRS, wave two as SB 154 in 2023 narrowing scope and the coastal trigger, wave three as HB 1021 and HB 1203 in 2024 adding records portals director education and criminal penalties, wave four as HB 913 in 2025 softening reserve requirements with two-year pause and raised threshold, and a fifth marker for HB 657 in 2026 that would have added a state-funded condo court but died in Senate Rules on March 13 2026, with each wave color-coded showing the progression from strict to softening enforcement
The four waves of post-Surfside Florida legislation, 2022-2026. Click to zoom.

Wave one — SB 4-D (2022). Signed by Governor DeSantis on May 26, 2022, eleven months after the collapse. Created mandatory milestone inspections under F.S. 553.899 for residential condo and cooperative buildings three or more habitable stories tall, with a 30-year statewide trigger and a 25-year trigger within three miles of the coast. Required Structural Integrity Reserve Studies (SIRS) every ten years and full reserve funding effective January 1, 2025. The law was the first major rewrite of Florida condo structural-safety regulation since the original Condominium Act.

Wave two — SB 154 (2023). Signed June 9, 2023. The "glitch bill" that adjusted SB 4-D's edges. Clarified that the inspection regime applied to residential condos only (not commercial), narrowed the coastal trigger from automatic three-mile to discretionary by local building official, allowed milestone inspection by a team of professionals with an engineer or architect responsible, removed floor and foundation from the items required to be reserved, added exterior doors to the reserve list, and increased the member-vote threshold for reserve waivers from a majority of quorum to a majority of total membership. The pattern of subsequent legislative softening had begun.

Wave three — HB 1021 and HB 1203 (2024). Both signed June 14, 2024 and effective July 1, 2024. HB 1021 reformed the Condominium Act with criminal penalties for repeated records violations (second-degree misdemeanor with intent to harm), accounting-record destruction (first-degree misdemeanor), and kickbacks (third-degree felony). The 25-unit website mandate for condo records took effect January 1, 2026. HB 1203 reformed Chapter 720 (HOAs) with a parallel criminal penalty regime, mandatory director education (4 hours per year, 8 for HOAs with 2,500 or more parcels), and a 100-parcel digital records portal effective January 1, 2025. Haber Law's white paper covers HB 1021 in detail.

Wave four — HB 913 (2025). Signed by Governor DeSantis on June 23, 2025 and effective July 1, 2025. House vote 112-0; Senate vote 37-0. The bill summary describes the substantial softening of Wave 1 requirements as financial pain on owners became visible: the SIRS deadline was extended from December 31, 2024 to December 31, 2025; associations whose budgets were adopted by December 31, 2028 and who completed milestone inspections in the previous two years could pause or reduce reserve contributions for up to two consecutive annual budgets by majority owner approval; the reserve threshold was raised from $10,000 to $25,000 (with annual inflation adjustment); reserve funding alternatives were expanded to include loans and lines of credit; mandatory online state registration for all condo associations took effect October 1, 2025; and the document review window for resale transactions was extended from three to seven days. Becker shareholder Joseph E. Adams's News-Press column walks through the changes.

The reform that died — HB 657 (2026). Sponsored by Rep. Juan Carlos Porras (R-Miami) with twelve co-introducers, HB 657 would have created a state-funded community-association court program in three judicial circuits, established a statutory mechanism for HOA dissolution, mandated Kaufman language in governing documents formed on or after July 1, 2026, eliminated pre-suit mediation for community-association disputes, and added explicit fiduciary-duty provisions for directors. The bill passed the House 108-2 on March 5, 2026 and died in Senate Rules on March 13, 2026 when the regular session adjourned without a hearing. It was the most ambitious community-association reform bill to clear either chamber since SB 4-D and is widely expected to refile in 2027.

The four-wave pattern is the underlying story. Florida built a strict post-Surfside framework in 2022. As reserve-study findings began producing six-figure special assessments in 2023 and 2024, the legislature progressively softened reserve requirements, extended SIRS deadlines, and added flexibility through loans and pauses. By the fourth wave in 2025, the softening exceeded the original tightening on the reserves dimension. The criminal-penalty and transparency provisions in Wave 3 remain in force.

What boards are doing differently

Board operations across Florida have changed materially in five years. The most visible operational shifts:

Boards that complied with the original SB 4-D requirements before HB 913's softening are generally in stronger structural and financial positions than boards that delayed. The post-Surfside pattern in operation: the buildings that took the law seriously in 2022 are not the buildings facing the worst special-assessment crises in 2026.

The financial fallout

98
Lives lost June 24, 2021
$1.02B
Court-approved settlement
1,438
FL condos on Fannie Mae blacklist (Mar 2025)
22%
Value loss on 30+ year buildings (2 yr)

The cost of post-Surfside compliance has produced a documented financial-distress pattern across older Florida condos. The named examples that have driven national reporting:

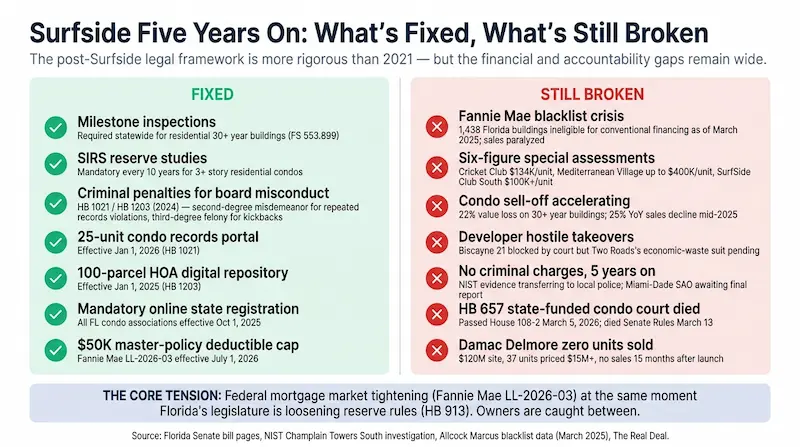

Side-by-side infographic showing what is fixed and what is still broken five years after Surfside. The Fixed column lists in green: milestone inspections required statewide for 30-plus year buildings, SIRS structural integrity reserve studies mandatory every 10 years, criminal penalties for board misconduct under HB 1021 and HB 1203, mandatory records portals at 25-unit condo and 100-parcel HOA thresholds, mandatory director education for HOAs, online state registration for all condo associations, and the 50-thousand-dollar Fannie Mae per-unit master-policy deductible cap effective July 1 2026. The Still Broken column lists in red: 1438 Florida condos on the Fannie Mae blacklist as of March 2025 with sales paralyzed, special assessments running over $134000 per unit at Cricket Club and up to $400000 at Mediterranean Village, the post-2024 condo sell-off with 22 percent value loss on 30-plus year buildings, developer hostile takeovers attempting amended thresholds blocked at Biscayne 21, no criminal charges filed five years on with NIST evidence transferring to local police, HB 657 state-funded condo court died in Senate Rules March 2026, and the rural-community squeeze with no targeted relief mechanism
Five years after Surfside — what is fixed and what is still broken. Click to zoom.

The mortgage-market fallout is documented in the Fannie Mae ineligibility list. As of March 11, 2025 (the most recent verifiable count from Allcock Marcus's confidentially-obtained dataset), 1,438 Florida buildings were ineligible for conventional Fannie Mae financing — with 696 in the Miami-Dade, Broward, and Palm Beach tri-county area combined. South Florida's count more than doubled in the two years preceding. Mortgage Professional America's April 2025 reporting documented the trend.

The price impact has been measurable. According to ISG World data cited by Newsweek, properties over 30 years old have lost approximately 22 percent of value over a two-year window. Florida Realtors data shows statewide condo prices declining monthly since July 2024. South Florida condo sales fell roughly 25 percent year-over-year in mid-2025, with median time-to-close exceeding 100 days across Miami-Dade, Broward, and Palm Beach.

The financial pressure has produced a parallel story in insurance. Master-policy premiums in many older condos have risen sharply since 2022. Fannie Mae Lender Letter LL-2026-03, issued March 18, 2026, will impose a $50,000 per-unit master-policy deductible cap mandatory for loan applications dated July 1, 2026 or later — effectively forcing buildings with high deductibles to either reduce them or accept ineligibility for conventional financing. The federal mortgage market is, in 2026, tightening condo rules at the same moment Florida's legislature has been softening reserve rules. The two trends are in tension.

The Biscayne 21 counter-current

While the Florida Legislature has progressively softened structural and reserve requirements, Florida's appellate courts have moved in the opposite direction on owner-protection. The clearest example is Avila v. Biscayne 21 Condominium, Inc., Case No. 3D23-1616, decided by the Third District Court of Appeal with a revised opinion on July 10, 2025.

Two Roads Development acquired 183 of 192 units in the 1964 Biscayne 21 building in 2022 for $150 million, planning to demolish for the Edition Residences luxury tower. The developer-controlled board amended the declaration in August 2022 to lower the termination threshold from 100 percent unanimous to 80 percent. The Third DCA reversed the trial court's denial of the holdouts' injunction and held that the original unanimous-consent requirement was a contractual right that could not be unilaterally amended — "absent Kaufman language, an amendment to the Condominium Act will not have retroactive application to a condominium's Declaration if it impairs contractual obligations," per Haber Law's Jonathan Goldstein and Christina Warhola in their July 2025 analysis.

The Florida Supreme Court denied review on October 14, 2025 (Case No. SC2025-1169), leaving the Third District ruling intact as binding precedent across Miami-Dade and Monroe Counties. On January 13, 2026, Miami-Dade Circuit Judge Thomas Rebull ordered Two Roads to restore the building to May 2023 condition after the developer had stripped windows, plumbing, and HVAC during pre-demolition activities. Restoration cost estimates ranged from approximately $61 million per Two Roads's own court filings to roughly $65 million per a separate Bank OZK report. The Fourth District Court of Appeal reached the opposite result on near-identical facts in Fellman v. Mission Viejo Condominium Association, 4D22-1260, in April 2023, creating a district split the Florida Supreme Court has declined to resolve.

The five-year pattern: the legislature softens financial requirements; the courts harden ownership protections. Florida's post-Surfside legal landscape is being shaped by two opposing forces simultaneously.

The criminal accountability gap

Five years on, no individual has been criminally charged in connection with the Champlain Towers South collapse. Miami-Dade State Attorney Katherine Fernandez Rundle convened a grand jury after the collapse, and the grand jury issued a 2024 report focused on prevention recommendations rather than charging individuals. The State Attorney's Office has stated publicly that it would await NIST's findings before deciding on criminal liability.

Engineering News-Record reported in late 2025 that NIST has begun transferring evidence to local police for the parallel criminal inquiry — signaling that 2026 or 2027 is the window in which criminal exposure could finally crystallize. Legal analysts have noted that manslaughter prosecution would face a high legal bar under Florida law, given the difficulty of attributing the collapse to specific decisions made decades after the building's 1981 completion. The accountability question, like the engineering report, remains formally open.

The Damac Delmore bookend

The most visible answer to "what has Florida built on the Surfside site?" is, five years on, "nothing yet." Damac Properties, the Dubai-based developer, paid $120 million for the 1.8-acre site in 2022. The replacement project, named The Delmore, is a 12-story, 37-unit luxury condominium designed by Zaha Hadid Architects with units priced from $15 million, an average of $35-$40 million, and penthouses over $150 million.

Sales launched in early 2025. As of April 2026, no units have sold. Damac Senior Vice President of Development Jeffrey Rossely told The Real Deal that the January 2025 launch "was premature" and that the company plans to relaunch sales toward the end of 2026 after resubmitting the master building permit, securing insurance, and finalizing a general contractor. Expected completion has shifted to 2029. Damac is reportedly in joint-venture talks with other developers.

The zero-sales status is itself the bookend to the five-year story. A Dubai investor paid $120 million for one of the most architecturally ambitious replacement projects in Florida; commissioned a Zaha Hadid Architects design; priced units at $15 million and up; and has not closed a single transaction in fifteen months on the market. The post-Surfside reality is that even glamorous redevelopment of the site itself is struggling.

Try Mosaic alongside your current software. No Risk!

See how Mosaic works
Always Human Support • Florida Built • Easy Cancellation

The memorial

The Town of Surfside has approved a permanent memorial design for the 98 victims. The conceptual design centers on a "wall of water" feature with an exhibition of materials recovered from the collapsed building, sited at the end of 88th Street and Collins Avenue across from the original site. Recovered materials are currently held at Veterans Park. The town held a Moment of Reflection event on February 4, 2026 marking the transition into the next phase. An annual Lighting of the Torch ceremony at 1:22 a.m. on June 24 reads the names of all 98 victims.

The design has been controversial. In April 2025, the city's planning and zoning board criticized the design publicly, with one member calling it "ugly as hell" and the chair later apologizing. Family member Martin Langesfeld defended the family-led design committee process. Tentative groundbreaking was set for early 2026. The dedication date has not been finalized as of this writing.

What comes next

Several inflection points are scheduled for 2026 and 2027:

The five-year arc is most accurately described as incomplete. Florida has built a regulatory framework that is more rigorous than what existed on June 23, 2021, but it has also walked back parts of that framework as financial reality landed on owners. The mortgage market has tightened where the legislature loosened. The courts have hardened where the legislature softened. And the physical site of the collapse, five years later, hosts neither a memorial nor a building — just a $120 million plot of beachfront waiting for the next attempt.

How Mosaic supports post-Surfside compliance

The compliance burden on Florida condo and HOA boards has grown materially since 2022. SIRS reports must be tracked. Milestone inspections must be coordinated with reserve studies. The 25-unit website mandate requires specific record types posted within specific time windows. Director education must be documented. Records access must be available within 10 business days of request. Mosaic's platform is built around the documentation infrastructure post-Surfside Florida boards now need:

Frequently asked questions

NIST's preliminary findings, communicated through 2025 updates by lead investigators Judith Mitrani-Reiser and Glenn Bell, identified the pool deck as the most likely origin of the collapse. The pool deck and street-level parking deck failed at least seven minutes before the tower itself came down. The initial failure point was a slab-column connection in the pool deck. Contributing factors NIST has cited include an original structural design that did not meet applicable building code requirements, misplaced steel reinforcement, heavy planters not in the original design, sand and pavers added during pool-deck rehabilitation decades earlier, and long-term corrosion of reinforcing steel from saltwater intrusion through failed waterproofing membranes. NIST announced in September 2025 that technical work was complete and that a draft summary report plus six technical reports would be released in Spring 2026. The agency has begun transferring evidence to local police for the parallel criminal inquiry by the Miami-Dade State Attorney's Office.

Approximately $1.02 billion, approved by Miami-Dade Circuit Court Judge Michael Hanzman on June 23, 2022 — one day before the first anniversary of the collapse. The largest single contributor was Securitas Security Services USA at $517.5 million. Other major contributions included $157 million from John Moriarty & Associates of Florida (the general contractor for the adjacent Eighty Seven Park development), approximately $400 million combined from Eighty Seven Park insurers, $25.7 million from NV5 (the geotechnical engineer), $25 million from Western Waterproofing, $16.5 million from Stantec's insurer, and $16 million from Morabito Consultants. Lead plaintiffs' counsel was attorney Harley S. Tropin. Court-appointed receiver Michael Goldberg confirmed no objections were filed and no claimants opted out. The bulk of the funds went to families who lost loved ones, with approximately $96 million earmarked for unit owners and approximately $100 million for legal fees.

Damac Properties, the Dubai-based developer, purchased the 1.8-acre site for $120 million in 2022. The replacement project, named The Delmore, is a 12-story, 37-unit luxury condominium designed by Zaha Hadid Architects with units priced from $15 million, an average of $35 million to $40 million, and penthouses over $150 million. Sales launched in early 2025. As of April 2026, no units have sold. Damac Senior Vice President of Development Jeffrey Rossely told The Real Deal in April 2026 that the January 2025 launch was premature, and the company plans to relaunch sales toward the end of 2026 after resubmitting the master building permit, securing insurance, and finalizing a general contractor. Expected completion is 2029. Damac is in joint-venture talks with other developers.

First wave: SB 4-D (2022), signed May 26, 2022, created mandatory milestone inspections under F.S. 553.899 and required Structural Integrity Reserve Studies (SIRS) every ten years for buildings three or more habitable stories. Second wave: SB 154 (2023), the so-called glitch bill, signed June 9, 2023, clarified that requirements applied to residential buildings only, narrowed the coastal trigger to within three miles of a coastline, and adjusted the items required to be reserved. Third wave: HB 1021 (condos) and HB 1203 (HOAs), both effective July 1, 2024, added digital records portals (25-unit threshold for condos effective January 1, 2026; 100-parcel threshold for HOAs effective January 1, 2025), mandatory director education, and criminal penalties for board misconduct. Fourth wave: HB 913 (2025), signed June 23, 2025, materially softened reserve requirements — extending the SIRS deadline to December 31, 2025, allowing a two-year reserve pause for milestone-coordinated repairs, raising the reserve threshold from $10,000 to $25,000, and adding a mandatory state registration requirement for condo associations effective October 1, 2025. HB 657 (2026), which would have added a state-funded condo court and an HOA dissolution mechanism, passed the House 108-2 on March 5, 2026 but died in Senate Rules on March 13, 2026.

Not as of May 2026. Miami-Dade State Attorney Katherine Fernandez Rundle convened a grand jury after the collapse, and the grand jury issued a 2024 report focused on prevention recommendations rather than charging individuals. The State Attorney's Office has stated it would await NIST's findings before deciding on criminal liability. NIST began transferring evidence to local police in late 2025 or early 2026, signaling that criminal exposure could crystallize during 2026 or 2027 once the final NIST report is released. Legal analysts have noted that manslaughter prosecution would face a high legal bar under Florida law, given the difficulty of attributing the collapse to specific individuals' decisions decades after the building's 1981 completion. The criminal accountability question remains open five years on.
