In Avila v. Biscayne 21 Condominium, Inc., Case No. 3D23-1616, Florida's Third District Court of Appeal handed nine holdout unit owners a decisive win against a developer that had acquired 183 of the building's 192 units and tried to amend the termination threshold from 100 percent unanimous down to 80 percent. The Florida Supreme Court declined to review the case on October 14, 2025, leaving the Third District's ruling intact as binding precedent across Miami-Dade and Monroe Counties. Read the opinion at justia.com. If you own a unit in an older Florida condo and have noticed an investment group quietly accumulating units in your building, this case — and the district split it has produced — is the single most important piece of Florida case law you need to understand.

Older waterfront Florida condos are now in the crosshairs of redevelopment activity that the post-Surfside structural-integrity framework has inadvertently accelerated. Bisnow reported in October 2025 that broker Dan Marinberg's Condobuyout.com had ten active Miami-Dade buyout deals in progress simultaneously. WLRN documented Florida's roughly 1.6 million condos, of which approximately 90 percent are 30 or more years old — the exact target population for the SIRS-and-milestone-inspection cost spiral that drives owners toward developer exits. For broader context, pair this with our Florida Fannie Mae blacklist guide, our SIRS reserve funding guide, and our milestone inspection guide.

This article is general information for Florida condo unit owners and board members. It is not legal advice. The legal landscape is shifting rapidly. Talk to a licensed Florida community-association attorney before relying on any specific provision or strategy.

Why developers are circling older Florida condos

Three forces converge to make older Florida condo buildings — particularly waterfront towers in Miami-Dade, Broward, and the Sarasota-Naples coast — unusually attractive acquisition targets right now.

First, the post-Surfside cost spiral. After Champlain Towers South collapsed in June 2021, killing 98 people, Florida enacted SB 4-D in 2022 and SB 154 in 2023 requiring milestone inspections and Structural Integrity Reserve Studies for buildings three or more habitable stories tall. Reserve funding deadlines and the SIRS reports themselves have produced six-figure special-assessment letters across Florida: WLRN reported that Cricket Club in North Miami issued assessments around $134,000 per unit and Mediterranean Village in Aventura imposed assessments up to $400,000 per unit. Owners who cannot pay become motivated sellers.

Second, the land-value math. Waterfront Miami land approved for new luxury construction is worth dramatically more than the existing aging structure. The Edition Residences, the Marriott-branded luxury tower Two Roads Development planned to build at Biscayne 21's address, would have generated returns that justified a $150 million acquisition for the existing 192 units. Across South Florida, similar redevelopment economics drive the buyout playbook.

Third, the Fannie Mae blacklist effect. Buildings flagged ineligible for conventional financing — because of insufficient reserves, deferred maintenance, master-policy gaps, or single-entity ownership concentration — sell only to cash buyers. Cash buyers tend to be developers and institutional investors. The post-2024 expansion of the blacklist has effectively narrowed the buyer pool for older Florida condos to the exact entities most interested in acquiring entire buildings.

Greenberg Traurig attorney David B. Weinstein, quoted in Florida Trend's April 2026 "Two Roads Diverged" feature, summarized the dynamic: investors are doing the math on aging buildings whose costs have outrun their cash flow, and the math often points toward acquisition rather than rehabilitation.

The Biscayne 21 case in plain English

Biscayne 21 is a 13-story, 192-unit waterfront condominium at 2121 N. Bayshore Drive in Miami's Edgewater neighborhood. It was built in 1964. The original 1965 declaration required 100 percent unanimous consent for termination of the condominium — a common provision in older Florida declarations.

In 2022, TRD Biscayne LLC, an affiliate of Two Roads Development, took on $150 million in financing and acquired 183 of the 192 units (95.3 percent), planning to demolish the building and replace it with the Edition Residences, a Marriott-branded luxury tower. The Real Deal documented the acquisition timeline.

In August 2022, the Two Roads-controlled association board amended the declaration to lower the termination threshold from 100 percent to 80 percent — the threshold currently allowed under F.S. 718.117(3). The amendment also added "Kaufman language" purporting to incorporate the Florida Condominium Act as amended from time to time. The nine remaining unit owners sued.

The trial court initially denied the holdouts' request for a preliminary injunction. The Third District Court of Appeal reversed in Avila v. Biscayne 21 Condominium, Inc., Case No. 3D23-1616 (Fla. 3d DCA Mar. 13, 2024), with a revised opinion on rehearing reported at 50 Fla. L. Weekly D1509 (Fla. 3d DCA July 10, 2025). The Florida Supreme Court denied review on October 14, 2025 (Case No. SC2025-1169) and denied a subsequent rehearing petition later that month, leaving the Third District ruling intact as binding precedent.

The Third District's reasoning, as Haber Law's Jonathan Goldstein and Christina Warhola explained: the original 100 percent unanimous-consent requirement gave each owner an effective veto over termination — a contractual right that the developer-controlled board could not unilaterally amend away to a lower threshold without violating the impairment-of-contract doctrine. Absent Kaufman language in the original declaration, generic post-recordation statutory references could not retroactively impair that contractual obligation. Bilzin Sumberg attorneys Joseph Hernandez, Kenneth Duvall, and Kevin Koushel covered the Florida Supreme Court denial in detail.

On January 14, 2026, a Miami-Dade trial court ordered Two Roads to restore the Biscayne 21 building — an estimated $61 million in repairs — after the developer had stripped windows, flooring, plumbing, and HVAC during pre-demolition activities. The Real Deal reported the order. Owner-side counsel Glen H. Waldman of Armstrong Teasdale summarized the holdouts' position: "You broke it, you fix it." Two Roads filed a new lawsuit in late January 2026 seeking equitable termination on an "economic waste" theory, arguing the building is now uninhabitable and should be terminated rather than restored. The case continues.

The Third / Fourth DCA split — which county matters

This is the part of the story most coverage misses, and it is the single most actionable insight for a Florida condo owner trying to assess their building's exposure.

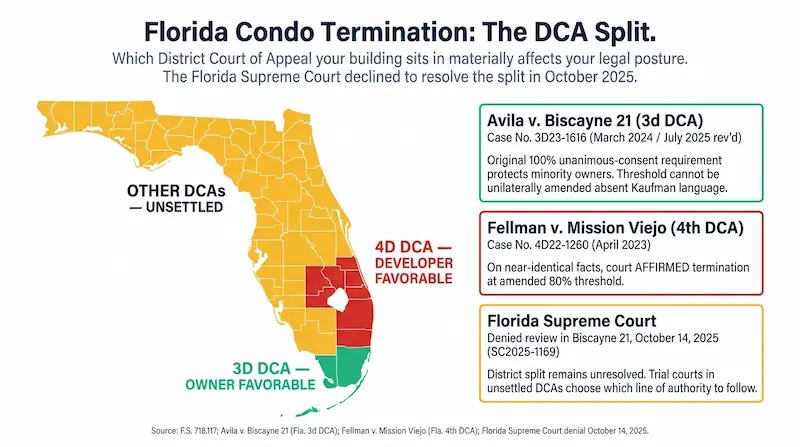

Map-style infographic showing the Florida District Court of Appeal jurisdictional split for condo termination cases with the Third DCA territory in Miami-Dade and Monroe Counties highlighted as owner-favorable under the Biscayne 21 ruling, the Fourth DCA territory in Broward Palm Beach Indian River Martin Okeechobee and St. Lucie Counties highlighted as developer-favorable under the Fellman v. Mission Viejo ruling, and notes for the Second DCA Fifth DCA First DCA and Sixth DCA where no controlling appellate decision yet exists, with a side panel listing the case names and citations and a note that the Florida Supreme Court declined to resolve the split in October 2025
Florida DCA jurisdictional split on condo termination — which DCA your building sits in matters legally. Click to zoom.

One year before Biscayne 21, Florida's Fourth District Court of Appeal reached the opposite result on near-identical facts. In Fellman v. Mission Viejo Condominium Association, Inc., Case No. 4D22-1260 (Fla. 4th DCA Apr. 6, 2023), the bulk owner held 175 of 176 units in a building whose 1980 declaration required 100 percent termination consent. The board amended to 80 percent in February 2021. The Fourth DCA affirmed termination. Read the opinion at justia.com. Kaye Bender Rembaum partner Jeff Rembaum's analysis walks through the doctrinal differences between Fellman and the emerging Biscayne 21 reasoning.

The Florida Supreme Court could have resolved this district split by accepting jurisdiction in Biscayne 21. It declined. The practical consequence is that which Florida DCA your building sits in materially affects your legal posture:

If your building is in Miami-Dade or Monroe County, the Third District's ruling is binding on the trial court. If your building is in Broward or Palm Beach, the Fourth District's contrary ruling is. If you live in any other Florida county, the law is unsettled and the outcome depends on which DCA your circuit reports to and which line of cases the trial judge finds more persuasive.

The 5 percent rule that actually wins

Most coverage of condo termination focuses on the 80 percent approval threshold. The more actionable number for minority owners is 5 percent. F.S. 718.117(3) provides that a Plan of Termination cannot proceed if 5 percent or more of total voting interests reject the plan by negative vote or written objection. Equally important: if rejected on this basis, the plan cannot be resubmitted for 24 months.

The math is straightforward and dramatically different from the math people imagine.

100 units
Need 5 owners to reject = block for 24 months
192 units
Need 10 owners (Biscayne 21 had 9 holdouts)
300 units
Need 15 owners to reject
24 months
Resubmission bar after rejection

Organizing 5 percent is dramatically easier than winning a contested 80 percent vote. The 5 percent threshold was lowered from 10 percent by SB 1520 in 2017 — making termination easier than the historical baseline — but the floor remains a meaningful defensive tool. Florida community-association attorneys consistently recommend identifying the 5 percent core and organizing them as the first defensive step when an attempted termination becomes visible.

The Kaufman-language audit you can do today

Before you call an attorney, before you call your neighbors, before you do anything else, you can answer the most important question about your building's vulnerability in five minutes. Pull your declaration from your county clerk's recorder website and search it for one phrase.

"Kaufman language" is a clause stating that the Florida Condominium Act applies to your building as amended from time to time, rather than as it existed when the declaration was recorded. The term traces to Kaufman v. Shere, 347 So.2d 627 (Fla. 3d DCA 1977). The clause typically reads something like: "The provisions of Chapter 718, Florida Statutes, as amended from time to time, shall apply to this Condominium" or similar.

If your declaration does contain Kaufman language, statutory amendments lowering termination thresholds (from 100 percent to today's 80 percent) generally apply to your building automatically. If your declaration does not contain Kaufman language — or if it contains language explicitly freezing the statute at the date of recording — the threshold in effect when the declaration was recorded is more likely to bind. This is the doctrinal hinge of Avila v. Biscayne 21: the absence of Kaufman language in the original declaration is what made the 100 percent unanimous-consent requirement a binding contractual right that survived later statutory amendments.

Pulling your declaration: most Florida county recorders post recorded condominium declarations on their public websites at no cost. In Miami-Dade, search the Miami-Dade Clerk's official records search by the association's name or recording reference. Other Florida counties have similar tools.

HB 913 and the economic-waste pathway

HB 913, signed by Governor DeSantis on June 23, 2025 and effective July 1, 2025, clarified the statutory definition of economic waste as a basis for termination and modified the bulk-owner termination pathway. Where a bulk owner holds 50 percent or more of voting interests, an economic-waste termination requires approval by 80 percent of all voting interests. Bryan Law's Shareen Agharaad has analyzed the interaction between HB 913 and the Biscayne 21 ruling.

Two Roads Development invoked the economic-waste pathway in its January 2026 follow-up lawsuit against the Biscayne 21 holdouts — arguing that because Two Roads itself had stripped the building during pre-demolition activities, restoration was now economic waste and the building should be terminated rather than rebuilt. The Miami-Dade trial court's January 14, 2026 order requiring restoration ($61 million) blunted that argument by re-establishing the building's habitability as a baseline. Siegfried Rivera attorney Lindsey Thurswell Lehr's March 2026 analysis covers the current state of play.

The economic-waste pathway is the next battleground for Florida condo developer takeovers. Owners watching their building face an aging-infrastructure narrative should pay close attention to how courts apply the new economic-waste definition over the next 12 to 24 months. The structural risk is that any developer with majority ownership could argue that needed repairs are uneconomic relative to redevelopment value, even where the building is in fact restorable.

Try Mosaic alongside your current software. No Risk!

See how Mosaic works
Always Human Support • Florida Built • Easy Cancellation

Owner playbook

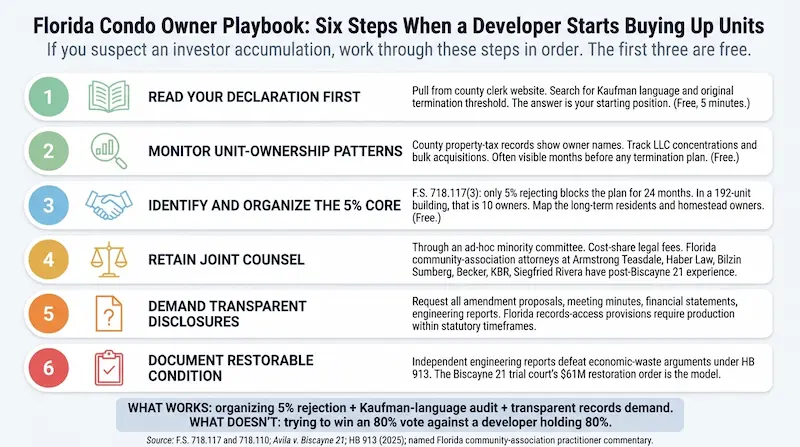

Six steps for Florida condo owners watching investor accumulation in their building.
